Activities in Logistics Phase 1
Demolition
Site Work and Preparation
Ground Improvement
Site Access
Deliveries and Vehicle access to the site will be via Szetela as the primary access point until the school years begin
Following the start of the 2024–2025 school year, this gate will be used from 8:30AM to 1:30PM
Activities in Logistics Phase 2
Foundation
Steel Erection
Wood Framing
Finishes
* Phase 2 will involve the use of crane for hoisting of material and equiptment.
* The crane will be located in the orange box shown on the site plan
Site Access
Deliveries and Vehicle access to the site will be via Szetela as the primary access point for contractor parking in coordination with school operating hours.
Bulk deliveries (steel, framing materials, equipment)
will be delivered via the Fort Ave gate.
Activity End:
10/18/24
Duration:
64 Days
Activity Start:
8/15/24
What are we doing?
Demolition activities will occur in a clockwise fashion.
The existing structures will be demolished down to foundations and foundations removed in bulk sections.
How are we doing it?
The process will use heavy equipment to knock the structures down in place.
Debris will be sorted by type for recycling as applicable and trucked away.
What are the impacts?
Noise / Minor Vibration
Operation of Equipment may include the use of a hydraulic hammer for foundation removal.
Activity End:
11/08/24
Duration:
21 Days
Activity Start:
10/18/24
What are we doing?
This activity is for the installation of rigid aggregate piers, as shown in the video.
This process is used to stabilize the soil to bear the load of the building.
What are the impacts?
Noise / Vibration
The vibration tolerances for this activity are closely monitored to ensure they remain within an acceptable treshold.
Activity End:
04/01/25
Duration:
102 Days
Activity Start:
11/08/24
What are we doing?
This activity will consist of excavation, construction of formwork, and placement of concrete within the building footprint.
Following foundations will be the erection of steel frame.
What are the impacts?
Noise
Hand Tools (Hammers, Saws etc)
Power Tools (Grinders etc)
Vehicle traffic from concrete and steel deliveries.
Activity End:
08/05/25
Duration:
162 Days
Activity Start:
02/24/25
What are we doing?

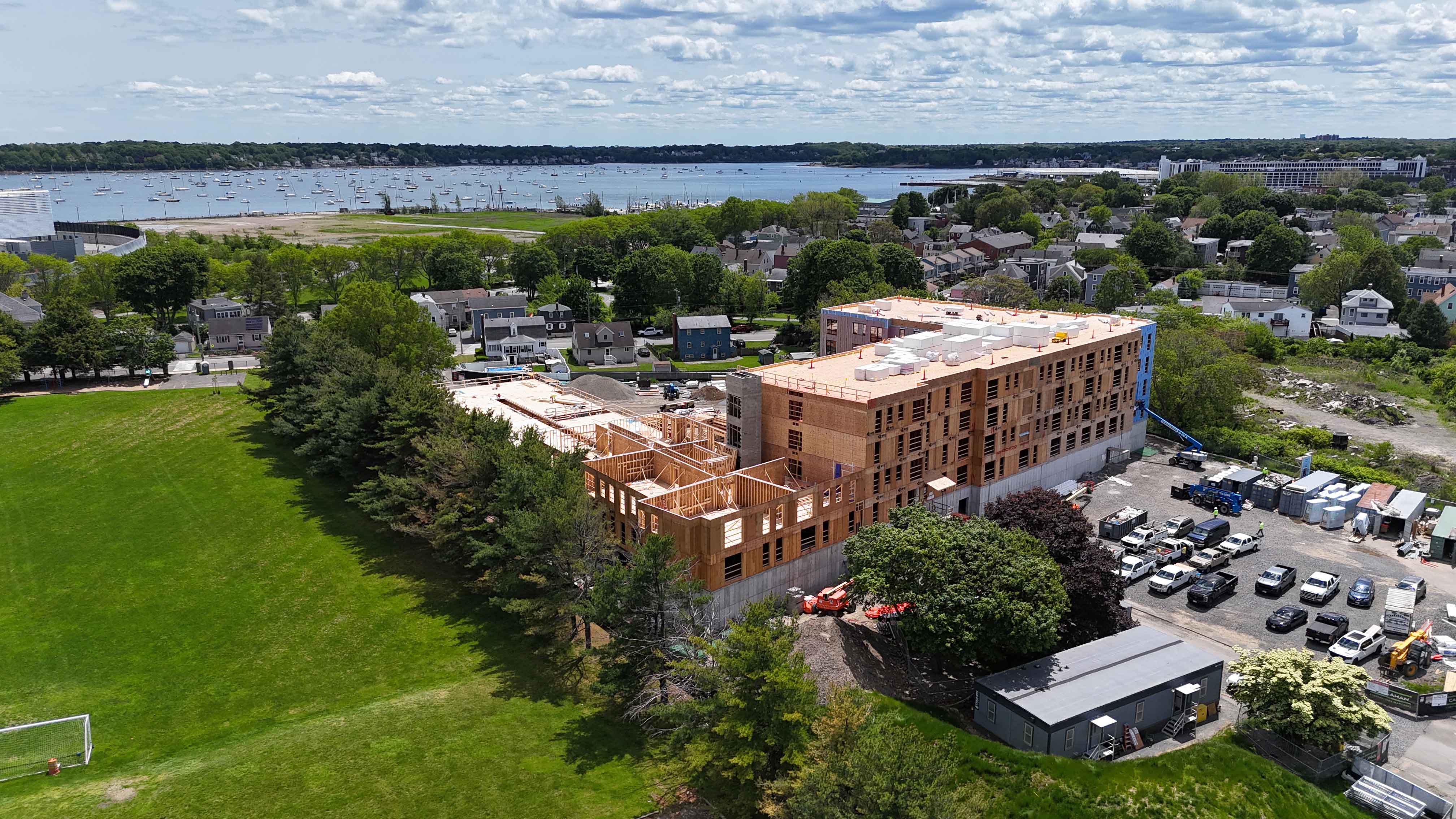

This activity will consist of the erection of the wood framed levels of the building
(level 1 through 4)
What are the impacts?
Noise
Hand Tools (Hammers, Saws etc)
Power Tools (Grinders etc)
Vehicle traffic from wood framing material deliveries.
Activity End:
04/06/26
Duration:
253 Days
Activity Start:
07/27/25
What are we doing?
This activity will consist of completion of exterior facade, interior MEPs, equiptment installation, and general interior finishes.
Exterior landscaping will occur in the final months of this activity.
What are the impacts?
General Construction Noise
Hand Tools (Hammers, Saws etc)
Power Tools (Grinders etc)
Vehicle traffic from concrete and steel deliveries.
This phase will involve the highest number of workers commuting to and
from the jobsite
Activity Start:
07/27/25
